30 findings validated with granular SIN data

32,142 DESSEM NE records on Feb 20, 2026: ZERO scheduled wind curtailment. Input = output. The model treats renewables as 100% dispatchable.

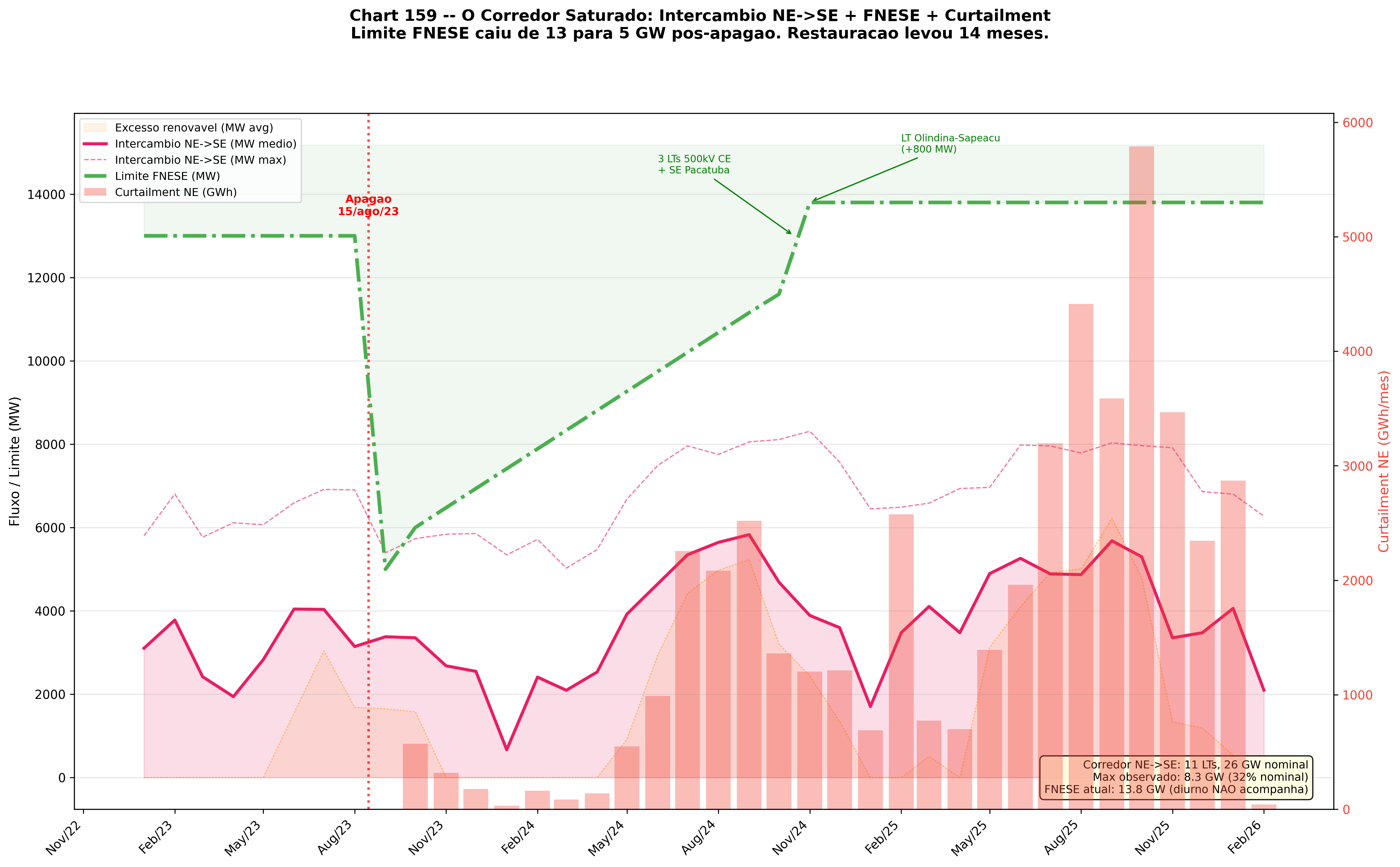

150 Mvar synchronous compensator offline since Oct/2025 causes 471 GWh of curtailment in the NE via FNESE constraint. Cost: R$ 115M in 116 days.

If the compensator were online, REL curtailment on the FNESE corridor would drop 85%. Projected savings: R$ 350-500M until return (Apr/2026).

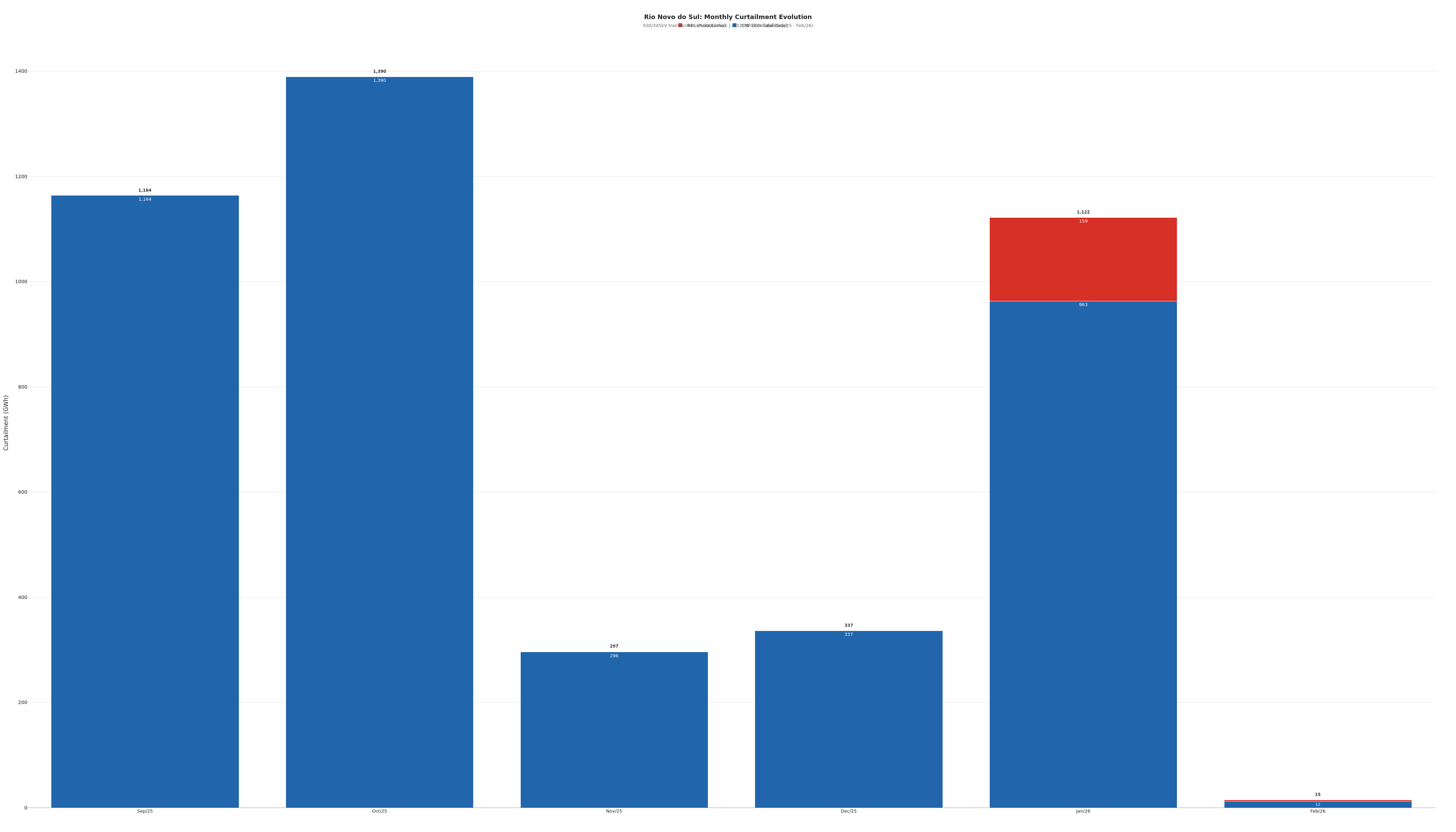

Full MG decomposition: (1) Itabira/Neves 500kV backbone, (2) Janauba-Jaiba 230kV corridor, (3) Rio Novo do Sul (shared with NE). 43.2% with specific attribution.

Curtailment per day is 44% higher on weekends (132.2 vs 91.8 GWh/day). CNF drops 60% on weekends, ENE rises 72%. Generators penalized when system has more slack.

Daily floor (P10) of curtailment: 455 MWh/day (2024) to 12,089 MWh/day (2025). CV dropped 27% (0.949 to 0.692). 41% of days with curtailment in all 24 hours.

Average of 20.2 hours/day with curtailment in 2025. Only 1% of hours free. It is no longer an event -- it is a permanent state of the system.

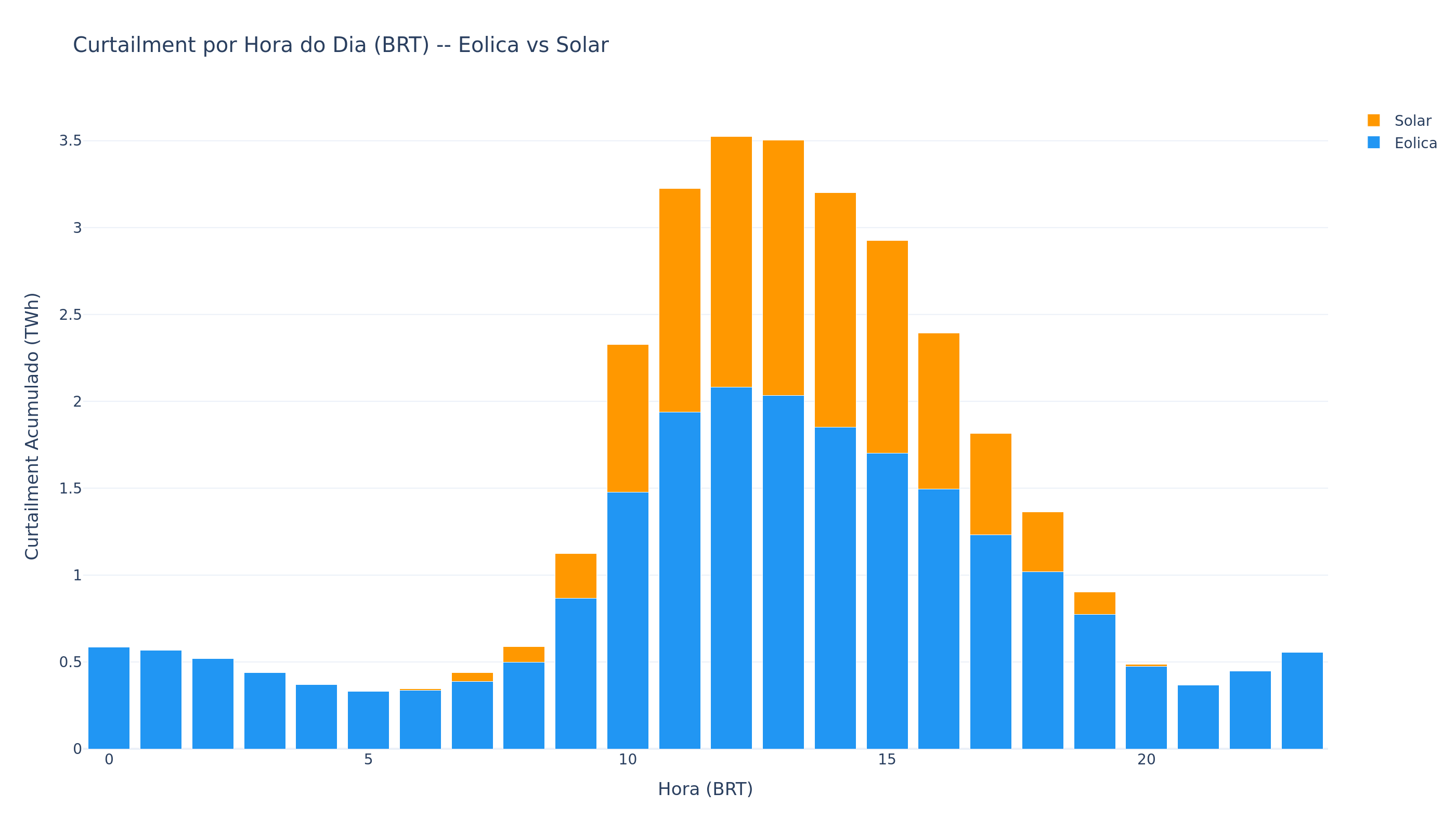

Optimal window by volume: 07-10 BRT (4,295 GWh, R$ 447M). By value: 12-15 BRT (2,497 GWh, R$ 2,497M). CMO spread R$ 176/MWh. 2.4x more revenue shifting 3h.

REL decomposition Jan/2026: FNESE 456 GWh (70%), Rio Novo do Sul 97.5 GWh (15%), FPOTPPA 75.5 GWh (12%). SGI Janauba 3 = 85% of FNESE.

DESSEM somflux on a WEAK day: peak IPER 28 (13:30 BRT) = 812 MW = 62.9% of 1,291 MW. Strong solar day reaches 100% and curtails. BESS 500 MW = -40% pressure.

CMO autocorrelation 0.916 but persistence R2=0.314. Direct XGBoost R2=0.506. CMO changes regime abruptly -- unlike curtailment which is gradual.

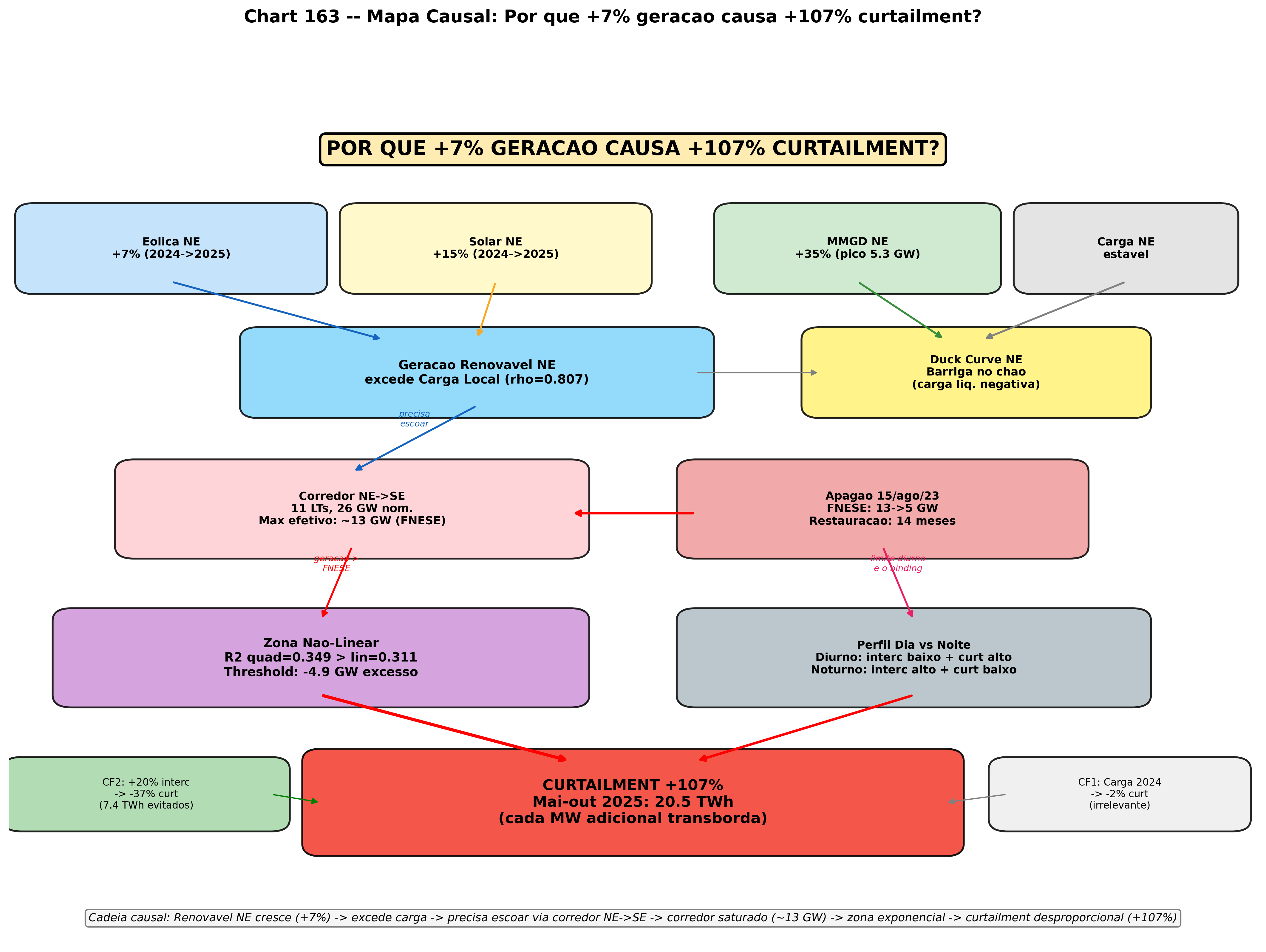

r=0.957 between curtailment and generation (identical to NE wind r=0.950). Proportional rate, not constant. Real difference: type of constraint, not weather sensitivity.

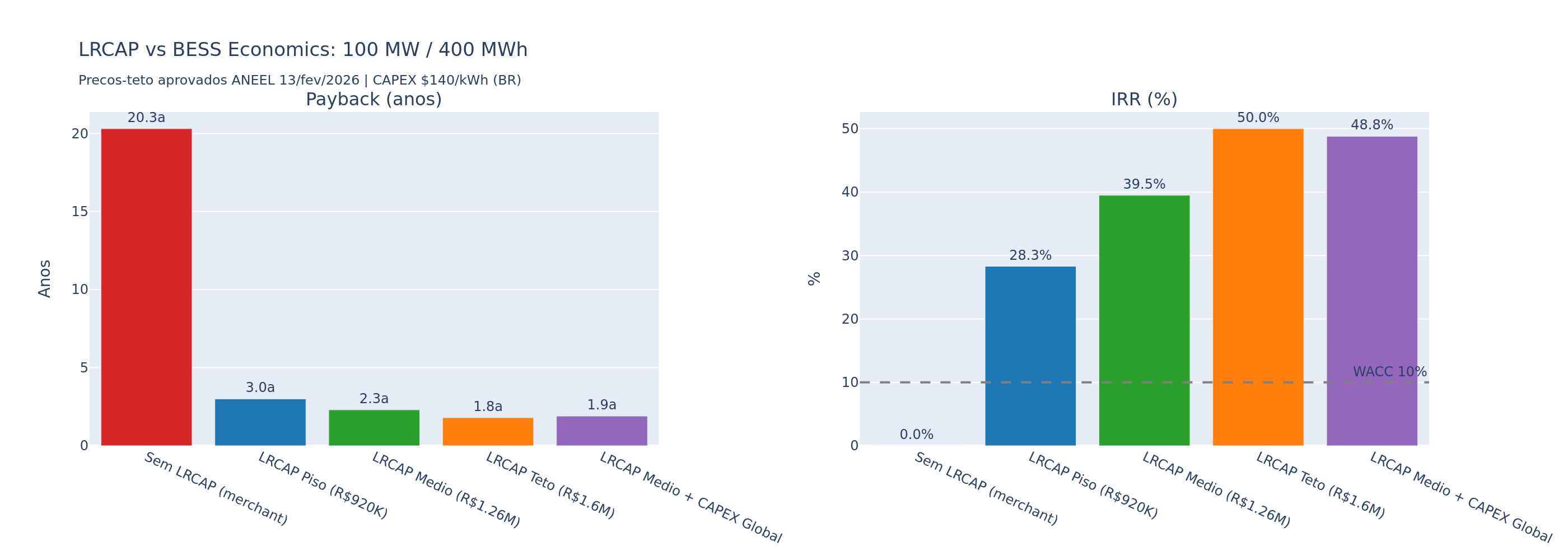

100 MW BESS: LRCAP R$ 290M + merchant R$ 27M/year. CapEx R$ 480M. Payback 1.6 years. Without LRCAP: 17.8 years. The auction is everything.

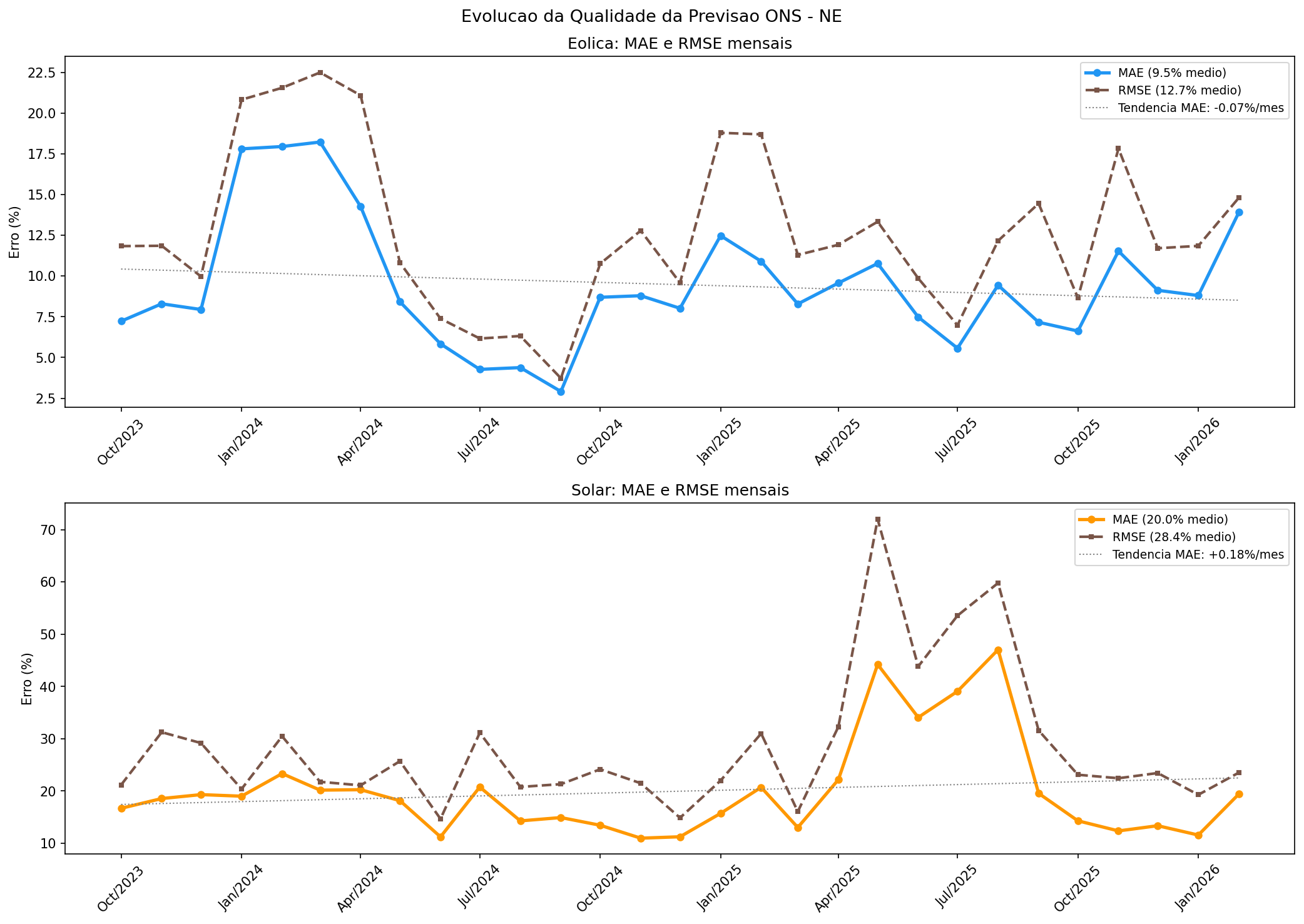

146 plants modeled. Per-plant XGBoost reduces median MAE by 48.1% (8.35 to 4.50 MW). Outperforms wind correction (-41.1%). Proof that forecasting is improvable.

CMO NE vs SE difference multiplied by curtailment. Average spread R$ 41/MWh, peak R$ 1,154/MWh. This is the cost that TX expansion would directly capture.

HHI 145 (2024) to 86 (2025). Top 5 clusters: 17.1% to 10.1%. No longer a problem of a few parks -- it is systemic. Monotonic deconcentration.

Logistic model calibrated by state: Base 57.4 TWh (+49%), Optimistic 53.3 TWh (+38%), Pessimistic 64.3 TWh (+67%). MG solar largest proportional mover (+81%).

Bahia surpassed RN as #1 state in Jan/2026. NE share: 20.5% to 42.6% in 1 month. 12 Bahia clusters in top growth. Driver: REL explosion (190x).

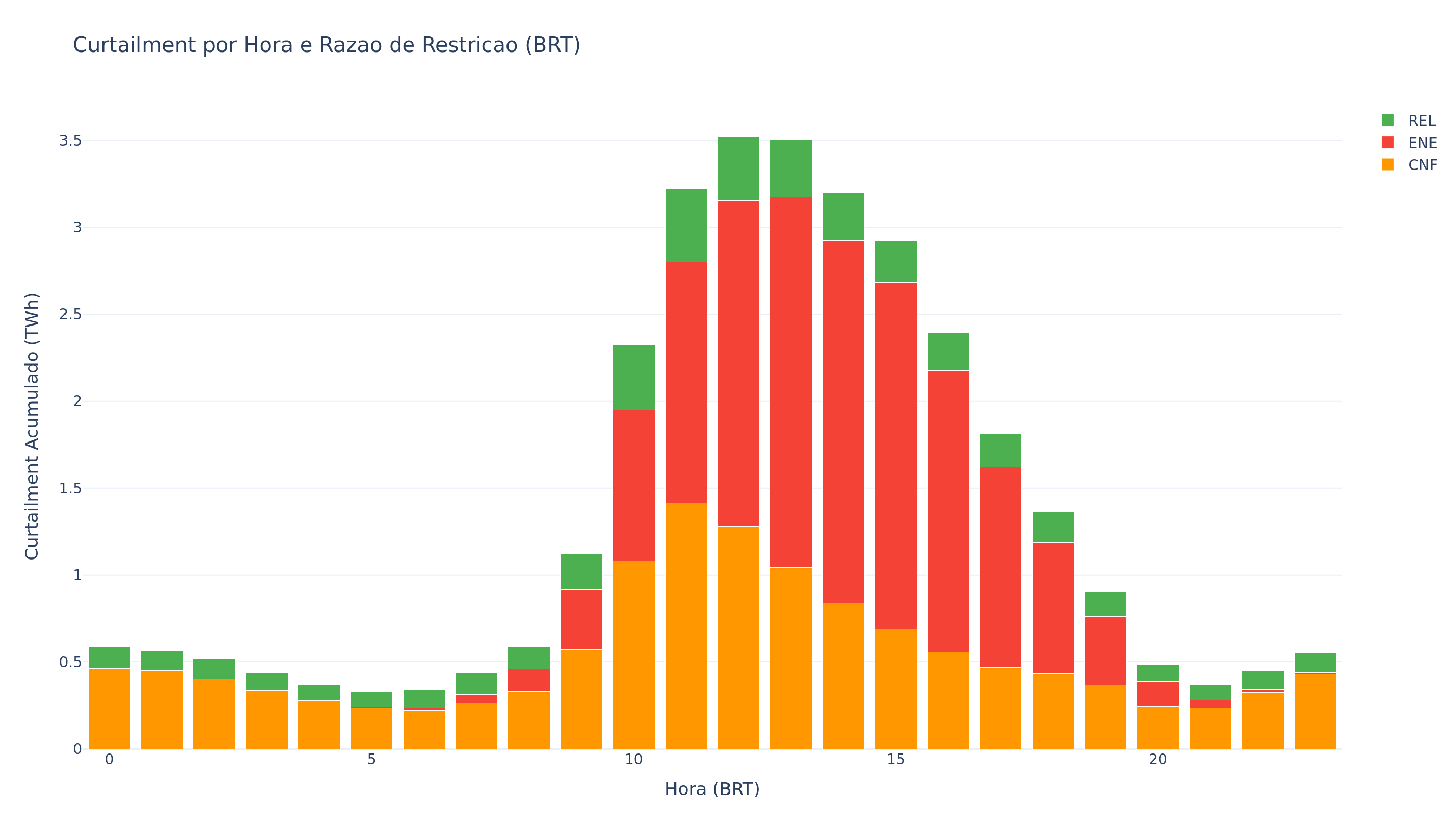

A 2-rule predictor (day regime + BRT hour) classifies CNF vs ENE with 87.5% accuracy. Mechanical crossover at 11h BRT. 232 of 236 clusters switch simultaneously.

DECOMP projected 739 MW NE thermal, actual was 1,223 MW. Porto Sergipe I burned gas at R$ 300/MWh while renewables were curtailed in the same subsystem.

Q3 nighttime collapsed: 31% to 18.7%. Zero night-dominant days in Q3/Q4 2025. Daytime ENE +335%, nighttime CNF +62%. Night will never surpass 50%.

Persistence+XGBoost: MAE 35.5 GWh (-14.9%). Direct XGBoost FAILS (R2=0.468). Calendar (day of week) is feature #1. 73.8% predictions within 50 GWh.

ANEEL Dispatch 188/2026: 153 plants (5.78 GW). Cumulative: 662 plants = 27.8 GW abandoned. 2x Itaipu capacity that will never be built.

DECOMP projected 2,190 MW SE solar, actual 5,854 MW (+167%). The entire impact of solar on operations is a weekly surprise.

Jumped from 0.631 (2024) to 0.750 (2025). Decorrelation doubled: 2 to 4 days. Curtailment is increasingly persistent and predictable. Baseload behavior.

CE wind: 53.9% to 59.0% (+5.1pp, decelerating). Physical grid limit creates self-regulated ceiling. All wind states converging to 50-55% by 2030.

1,399 periods with the Northeast IMPORTING energy since 2023. Minimum: -1,916 MW (Feb 4, 2026). A system designed to export, not import.

ONS approved 7,298 MW in the first Redata batch. Total 26.2 GW in requests. Potential to absorb energy that is currently wasted in the NE.

BESS market tripled in 2025. WEG building 2 GWh/year factory in Itajai. BNDES financing R$ 280M. Structural turning point.

50 per-cluster XGBoost models. Median MAE reduction: 41.1%. ONS VP curve has systematic bias correctable with ML. Applicable to 236 clusters.
